House construction contract — घर निर्माण सम्झौता

Between the person building and the ठेकेदार: rate, stages, materials, delay and defects.

Write a construction contract — free Free · no sign-up · nothing you type leaves your device

In short

A house construction contract (घर निर्माण सम्झौता, or ठेक्का सम्झौता) is the agreement between the owner and the contractor building the house. It says what the price covers — labour only, or labour and materials — the rate per square foot or the total, when each payment is due as the work reaches each stage, the completion date and the penalty for delay, and who repairs defects after handover.

Building a house is the largest payment most families here ever make, usually to a ठेकेदार on a rate per square foot agreed by word. The arguments come later and they are always the same five: what that rate included, who was buying the cement, when the money was due, why it is three months late, and who fixes the crack.

On this page
  1. The five things that cause disputes
  2. Labour contract or full contract?
  3. Before the work starts
  4. The workers on site
  5. घर निर्माण सम्झौताको नमुना — पूरा कागज
  6. घर निर्माण सम्झौता बनाउने — make a house construction contract online
  7. Common questions

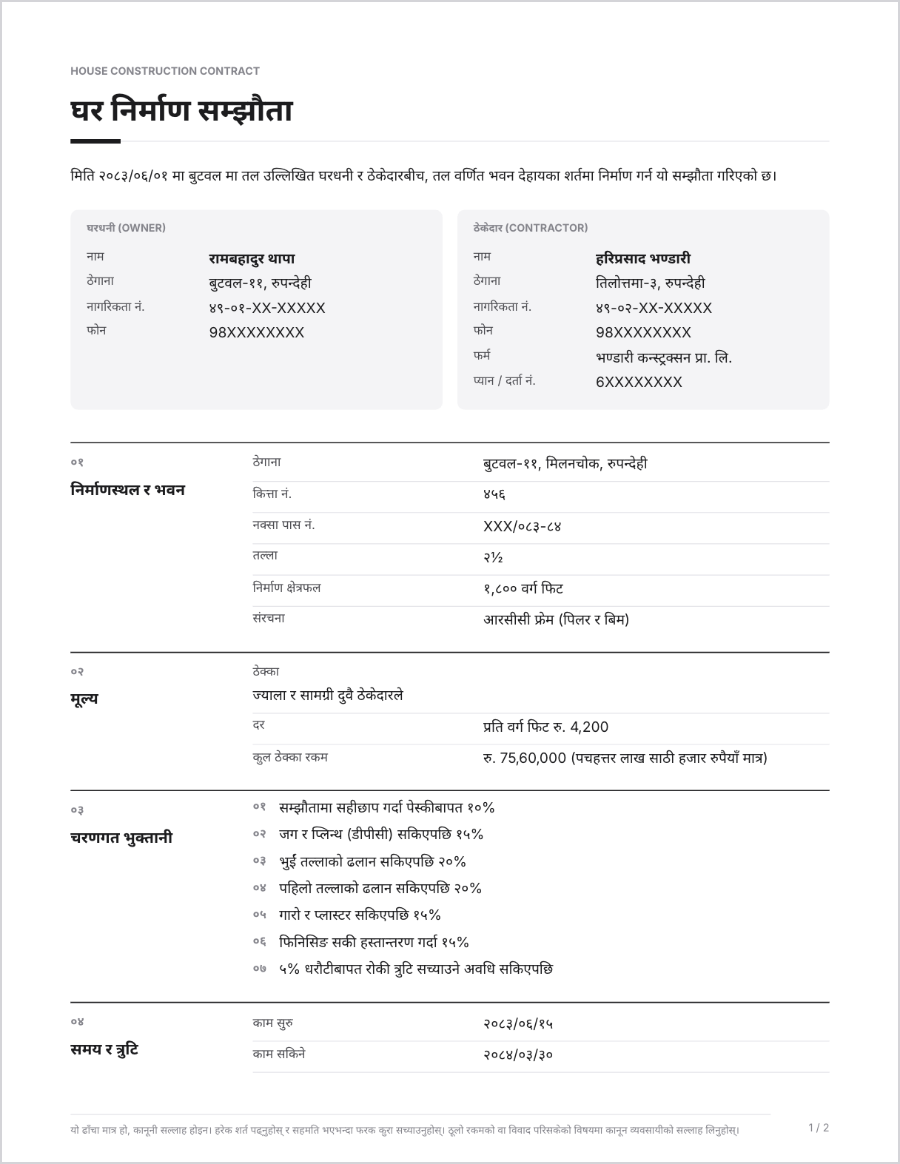

घर निर्माण सम्झौताको नमुना — sample house construction contract in Nepali, filled in
घर निर्माण सम्झौताको नमुना — sample house construction contract in Nepali, filled in — made with this tool. The names are invented. The same नमुना as text, to copy ↓
Download sample PDF Download Word format (.docx) Or fill in your own below — free, nothing uploaded.

The five things that cause disputes

What the rate covers. A rate per square foot means nothing until it says whether it includes materials, finishing, electrical and plumbing work, and the boundary wall.

Who supplies the materials. In a labour contract the owner buys them; in a full contract the contractor does. Write down which, and list any the owner supplies.

Payment by stage. Pay for work done, never ahead of it — an advance, then a share at the foundation, each slab, the walls and plaster, and handover. The template's stages are editable.

The completion date and the penalty for delay, with the reasons the date may move: the owner's own delay, a disaster, a government restriction.

Defects after handover. A defects period — commonly a year — in which the contractor repairs cracks and leaks at their own cost, and a share of the price held back until it ends.

Labour contract or full contract?

ज्याला ठेक्का (labour only). The contractor brings the workers; the owner buys the materials. The owner controls quality and price of materials, and carries the work of buying and storing them.

सामग्रीसहित ठेक्का (labour and materials). The contractor supplies everything for one price. Simpler for the owner, and the place where quality is most often cut — so the grade and brand of cement, rods and bricks belong in the contract.

Many contracts are a mix. The form asks which, and lists what the owner supplies.

Before the work starts

Your municipality must approve the building's drawing and issue a permit (नक्सा पास) before construction begins; what it asks for varies by municipality, so ask the ward or the municipality's engineering section. Put the permit number in the contract, and a clause that the contractor builds to that drawing.

For anything beyond a small single storey, an engineer who checks each stage before it is paid for is worth what they cost. The template's payment clause says a stage is paid once the owner or the owner's engineer has checked it.

The workers on site

The workers are the contractor's, and the National Civil (Code) Act's chapter on wages applies to them: wages as agreed or at the local rate (section 641), adequate safety measures (section 642), an eight-hour day unless the worker agrees to more and is paid for it (section 643), and work once taken on not left unfinished without good reason (section 645).

The template puts the workers' wages, hours, safety and any accident on the site with the contractor, and lets the owner finish an abandoned job through someone else at the contractor's cost.

घर निर्माण सम्झौताको नमुना — पूरा कागज

घर निर्माण सम्झौता

मिति: [२०८३ असोज १]

घरधनी: [पूरा नाम], [ठेगाना], ना.प्र.नं. [नम्बर]

ठेकेदार: [पूरा नाम], [ठेगाना], ना.प्र.नं. [नम्बर], फर्म [नाम], प्यान [नम्बर]

भवन: [ठेगाना], कित्ता नं. [नम्बर], नक्सा पास नं. [नम्बर] — [२½] तल्ले, [१,८००] वर्ग फिट, आरसीसी फ्रेम।

ठेक्का: [ज्याला र सामग्री दुवै ठेकेदारले], प्रति वर्ग फिट रु. [४,२००] — कुल रु. [७५,६०,०००।–] (अक्षरेपी पचहत्तर लाख साठी हजार रुपैयाँ मात्र)।

भुक्तानी: सहीछाप गर्दा १०%, डीपीसी सकिएपछि १५%, भुईं तल्लाको ढलानपछि २०%, पहिलो तल्लाको ढलानपछि २०%, गारो र प्लास्टरपछि १५%, हस्तान्तरणमा १५%, र ५% त्रुटि सच्याउने अवधि सकिएपछि।

समय: काम [२०८३ असोज १५] मा सुरु भई [२०८४ असार ३०] भित्र सकिनेछ। ढिलाइमा प्रतिदिन रु. [२,०००] कट्टा। हस्तान्तरणपछि [१२] महिनाभित्र देखिएका त्रुटि ठेकेदारले आफ्नै खर्चमा सच्याउनेछ।

ठेकेदारले स्वीकृत नक्साबमोजिम निर्माण गर्नेछ। कामदारको ज्याला, सुरक्षा र निर्माणस्थलको दुर्घटनाको जिम्मेवारी ठेकेदारको हुनेछ।

घरधनी: [हस्ताक्षर]
ठेकेदार: [हस्ताक्षर]
साक्षी १: [नाम] · [ना.प्र.नं.]
साक्षी २: [नाम] · [ना.प्र.नं.]

घर निर्माण सम्झौता बनाउने — make a house construction contract online

  1. Enter the owner and the contractor, with the contractor's firm and PAN if there is one.
  2. Describe the site and the building: address, kitta number, building permit number, storeys, area and structure.
  3. Say whether the price covers labour only or labour and materials, the rate per square foot or the lump sum, and the total.
  4. Set the payment for each stage, the amount held back, the defects period, the start and completion dates and the delay penalty.
  5. Add the witnesses and choose Nepali or English. Download it as a PDF, or as a Word file you can still edit. It is free, there is no sign-up, and nothing you type is uploaded.
Write a construction contract — free

Common questions

What should a house construction agreement include?

Both parties; the site with its kitta and building permit numbers; what the price covers and who supplies the materials; the rate or total; payment by stage; the start and completion dates and the delay penalty; the defects period and the amount held back until it ends; and who is responsible for the workers. Then the witnesses' signatures.

What is retention, or धरौटी, in a construction contract?

A share of the price — five percent is common — held back from the last payment until the defects period ends. It is what makes a contractor come back to fix a leak a year later.

Should I pay the contractor in advance?

A small advance to start is usual. After that, pay each stage once it is done and checked, never ahead of it. The template's stages add up to a hundred percent and are editable.

What is a thekka samjhauta?

ठेक्का सम्झौता is a contract for a job done for an agreed price — here, building a house. A घर निर्माण सम्झौता is the same agreement named for what it builds.

Is my information sent anywhere?

No. Everything stays in your browser. Nothing is uploaded, and there is no account unless you make one to sync your work across devices.

In this topic

Agreements and legal papers

Agreement formats for a house, land, a vehicle, a loan or a business, and the papers that go with them.

Agreement papers in Nepal — the whole subject in one place

Agreements

Legal papers

Last updated

Other tools

A hand holding house keys in a doorway House rent agreement Fill in the details and download a complete agreement, ready to sign. Two people handing over a vehicle’s keys in a car park Vehicle sale agreement Selling a bike or a car — record it properly, in one page, ready to sign. Terraced fields on a hillside in Nepal with the Himalaya behind Land sale agreement (बैना) The advance-payment agreement made before राजिनामा — written down properly. Hands counting cash over a wallet and papers Loan agreement · तमसुक Lending money to someone? Write it down before it goes wrong. An employment contract being handed across a desk Employment contract Put the job, the pay and the notice period in writing — for both sides. Two business partners shaking hands over a signed agreement Partnership agreement Starting a business together — settle the hard questions while they are easy. A signed certificate with a red seal Certificate Participation, prize, appreciation and training certificates in eleven designs — plus experience, character and salary letters. Print a whole list at once. Financial forms and a calculator on a desk Affidavit of financial support · आर्थिक जमानतनामा Who is paying for your study abroad, how much, and where the money comes from. A man writing an application by hand at a desk Application to a ward office · निवेदन नाता प्रमाणित, बसाइँसराइ, दर्ता, सिफारिस — the opening line every office expects. A person writing a statement in a notebook Complaint to the police (जाहेरी) The structure a police office expects — so your complaint is not handed back. A small child waiting in an airport lounge Consent letter for a minor's travel For a passport, a visa, an airline or a school trip — in the form they ask for. A hand signing a document with a pen Signature Draw it or photograph it, get a clean transparent PNG — and put it on your documents. A young family — two parents holding their child Relationship certificate in English Your ward's नाता प्रमाणित, translated into the English an embassy expects. Sample salary slip in Nepal showing earnings, deductions and net pay Salary slip Earnings, deductions and net pay on one page, with the totals worked out for you. Sample appointment letter (नियुक्ति पत्र) on a company letterhead in Nepal Appointment letter The post, the joining date, the salary and the terms, on your letterhead. Sample job offer letter with salary structure and acceptance line Job offer letter The position, the salary structure and the date the offer lapses. बैठकको माइन्युटको नमुना — sample meeting minute in Nepali with attendance, agenda and decisions Meeting minute Attendance, agenda and numbered decisions, in the order an office expects. मञ्जुरीनामाको नमुना — sample manjurinama consent letter in Nepali मञ्जुरीनामा — letter of consent Your written consent, in the wording a land, bank or government office reads. अधिकृत वारेसनामाको नमुना — sample power of attorney in Nepali अधिकृत वारेसनामा — power of attorney Authorise someone to act for you, with the powers listed one by one. बिदाको निवेदनको नमुना — sample leave application in Nepali for an office Leave application — बिदाको निवेदन For an office, a school or a campus, in Nepali or English, ready to sign. जागिरको लागि निवेदनको नमुना — sample job application letter in Nepali Job application — जागिरको लागि निवेदन The formal application that goes with your CV, in Nepali or English, ready to sign. राजीनामा पत्रको नमुना — sample resignation letter in Nepali Resignation letter — राजीनामा पत्र Short and polite, with your last working day, in Nepali or English. कोटेसनको नमुना — sample quotation in Nepali with items, VAT and total Quotation, estimate and bill — कोटेसन Type the items; the amounts, the total and the words are worked out. जग्गा भाडा सम्झौताको नमुना — sample land lease agreement in Nepali, filled in Land lease agreement — जग्गा भाडा सम्झौता Farmland, a plot for a shed or a shop — let in writing, within the limits the law sets. भरपाईको नमुना — sample receipt in Nepali for rent paid in cash, filled in Receipt — भरपाई For rent paid in cash, a loan repaid, an advance on land — the paper that proves the money changed hands.
